Bill of Materials Manufacturing Execution and Planning System Material Requirements Planning

How Does the Manufacturing Bill of Materials Work in the MRP Process?

by Swapnil Shah |
How Does the Manufacturing Bill of Materials Work in the MRP Process?

In the world of manufacturing, efficient planning is the backbone of reliable operations, and material requirements planning (MRP) plays a central role in making that possible. So what powers the MRP engine to generate accurate material plans? It starts with a well-structured manufacturing bill of materials.

This blog explains what MRP is and how a well-structured manufacturing BOM supports and strengthens the planning process within MRP systems. You will learn how MRP uses BOM data to calculate material needs, what sources of demand drive those calculations, and how it translates into real-world impact across procurement, production, inventory, and finance.

A manufacturing bill of materials (MBOM) is the structured list of every component, sub-assembly, and quantity needed to build a finished product, and it is the core input the MRP engine uses to calculate what to purchase and produce.

What Is Material Requirements Planning (MRP)?

Material requirements planning (MRP) is a method used to manage manufacturing by making sure materials are available when needed, reducing excess inventory, and optimizing production scheduling. It aligns material demand with available inventory and scheduled receipts, then proposes the requirements for raising purchase orders and work orders. By synchronizing material availability with production priorities and capacity, the MRP process minimizes shortages and lateness, prevents overstocking, and promotes efficient use of resources across the manufacturing workflow.

At a high level, the MRP process moves through a repeatable flow:

  • Read demand from sales orders and forecasts
  • Check current inventory to see how much demand is already covered
  • Explode the manufacturing BOM to break finished-goods demand into component needs
  • Net the requirements by subtracting what is on hand at each level
  • Generate recommendations to purchase externally or produce in-house, each with a required-by date

Key Elements the MRP Process Depends On

The MRP process relies on four key inputs working together:

  • Master production schedule (MPS). Defines what products need to be produced, in what quantity, and by when. It is the primary input driving all material planning decisions.
  • Manufacturing BOM. Provides the complete breakdown of all components and sub-assemblies needed to build each product. MRP uses it to determine material quantities.
  • Inventory data. Reflects current stock levels and availability. Accurate inventory data helps MRP calculate what needs to be procured or produced, avoiding overstocking or stockouts.
  • External demand signals. Dynamic inputs such as customer sales orders, stock transfers, and forecasts that the MRP process uses to compute requirements.

Internal inputs such as the MPS and inventory data, together with external inputs such as sales orders and forecasts, feed the MRP process. The BOM acts as the recipe for production, helping the engine answer three planning questions: what do we need, how much do we need, and when do we need it?

Importance of the Manufacturing Bill of Materials in MRP

Of those inputs, the manufacturing BOM is the one the whole calculation is built on. It outlines every component, assembly, and sub-assembly needed to manufacture a finished product, and that detailed breakdown is what lets MRP match material demand to supply accurately.

Without an accurate manufacturing BOM, the MRP engine cannot generate reliable procurement or production plans. A missing component, a wrong quantity ratio, or an outdated revision flows straight into the plan and produces shortages, excess stock, or the wrong parts on the floor. Whether it is maintained in dedicated BOM management software or a simple spreadsheet, the accuracy of the BOM sets the ceiling on how good the plan can be.

A clear, updated BOM supports better resource utilization, reduces costs, improves cross-functional coordination, and enables confident, data-driven decisions. That is what makes it a foundational part of efficient and scalable manufacturing operations.

Real-World Scenario: How the Manufacturing BOM Drives MRP

To illustrate the role of the manufacturing BOM in MRP, here is a simplified scenario for a skateboard built on a multi-level BOM, where a finished product breaks down into sub-assemblies and those break down further into raw materials.

The finished skateboard requires 2 stickers, 1 warranty card, 1 transfer, and 1 deck. The deck is manufactured in-house from one unit each of glue, ply, face, and core. A minimum stock level of 20 units is set for all components.

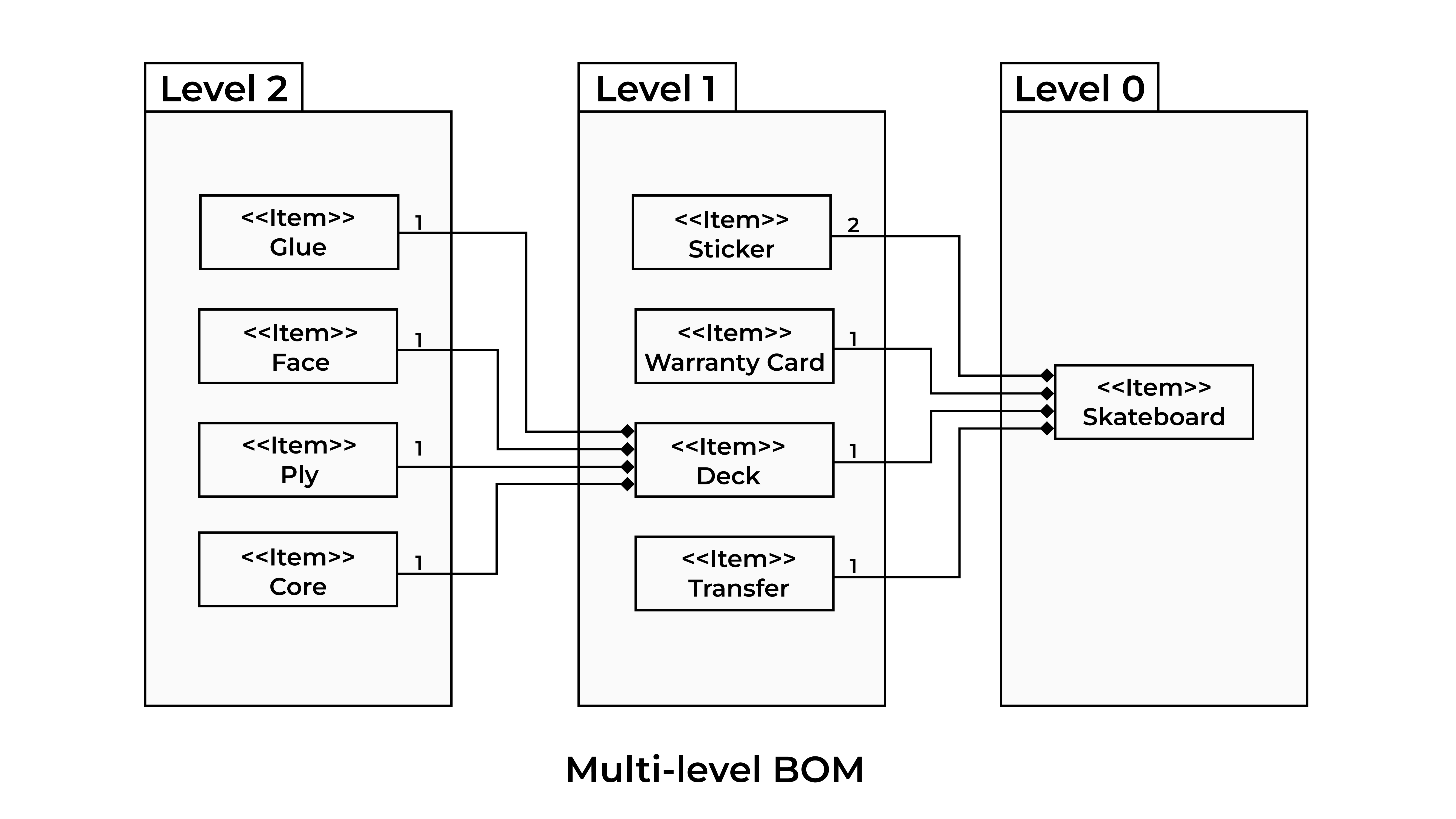

Multi-level BOM breakdown for a skateboard

ABC Company receives sales orders totaling 500 skateboards. The MRP engine uses this BOM to calculate exactly how much of each material is needed:

  • Stickers: 2 per skateboard, so (500 × 2) + 20 minimum stock = 1,020 units required. With 100 in stock, MRP suggests 920 units to procure.
  • Warranty cards and transfers: 1 per skateboard, so (500 × 1) + 20 = 520 units required. With 100 in stock, MRP suggests 420 units to procure each.
  • Deck sub-components (glue, ply, face, core): 1 per skateboard, so 520 units required each. With 100 in stock, MRP suggests 420 units to procure each.

The skateboard and deck are produced in-house, so MRP does not propose procurement for them. It calculates that 520 units of each need to be produced to meet both sales orders and minimum stock. If the deck already has 100 units in stock against a minimum of 20, only 420 additional decks need to be produced.

Summary of Material Requirements Generated

  • Stickers: 920 units to purchase
  • Warranty cards: 420 units to purchase
  • Transfers: 420 units to purchase
  • Glue, ply, face, and core: 420 units each to purchase
  • Deck: 520 units to produce in-house
  • Skateboard: 520 units to produce in-house

By breaking the skateboard down into its components and sub-assemblies, the BOM gives the MRP engine the data it needs to calculate exactly how much of each material is required, right down to the glue and ply used in the deck. Without this detailed, multi-level structure, MRP could not translate 500 skateboard orders into precise material requirements.

Conclusion

The relationship is simple: the MRP engine is only as accurate as the manufacturing BOM behind it. The BOM defines every component, sub-assembly, and quantity that goes into a product, and MRP turns that structure into precise purchase and production requirements. When the BOM is right, material planning falls into place. When it is wrong, the same errors reach procurement, production, and inventory alike.

That accuracy is hard to hold in spreadsheets, where BOMs drift out of sync with how products are actually built. A system that keeps the BOM structured, versioned, and connected to planning is what makes MRP dependable as operations grow, and choosing the right MRP software is a large part of getting there.

HotWax Systems helps manufacturers set up and customize Apache OFBiz to do exactly that: maintain multi-level manufacturing BOMs and feed them directly into an MRP engine that supports full material requirements planning, with the HotWax Accelerator adding faster development, integrations, and real-time visibility across the supply chain.

Ready to structure your manufacturing BOM and connect it to a reliable MRP engine? Talk to our team of experts at HotWax Systems to see how Apache OFBiz can support your operation.
